Leson1
Finding Diffs Between Larger Files
commits is a check point
Command
VSC

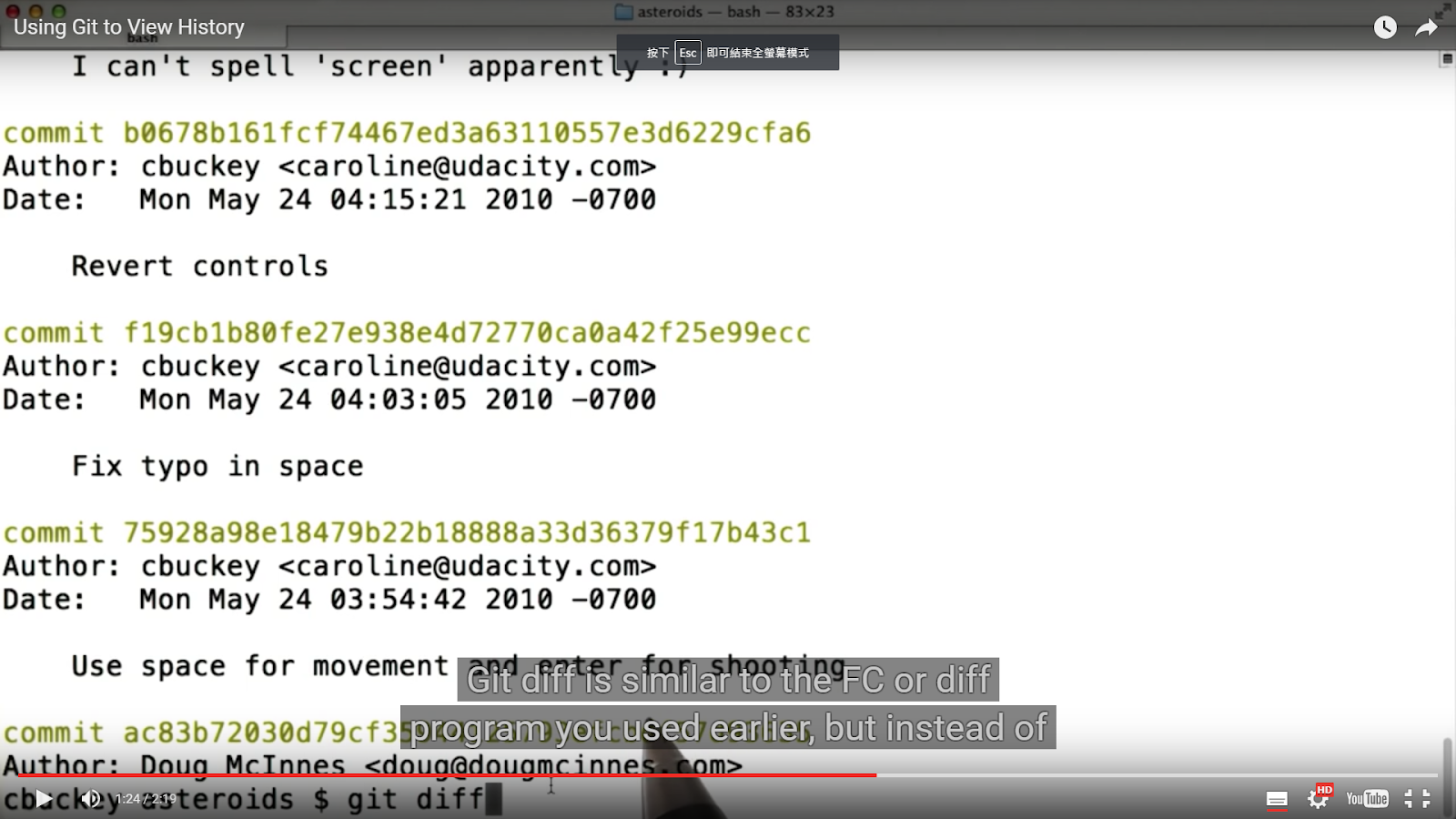

git log (see the history)
git diff old new
git log --stat
git checkout id (go to the past)
git clone https://github.com/udacity/asteroids.git ( clone a repository )
How Often to Commit
good rule of thumb is to make one commit per logical change. For example, if you fixed a typo, then fixed a bug in a separate part of the file, you should use one commit for each change since they are logically separate.
Quiz
One Commit per Logical Change Solution
You commit all the changes required to add a new feature, which you’ve been working on for a week. You haven’t committed since you started working on it.
This commit seems too big. It's easier to understand what each commit does if each only does one thing and is fairly small. Going a week without committing is not the best idea.
You found three typos in your README. You fix and commit the first.
This commit seems too small. It would be better to fix all three typos, then commit. That way, your history won't get too cluttered with typo fixes. Plus, you don’t need to worry about introducing bugs to a README, so bundling changes together is more likely to be a good idea.
You commit all the changes required to add a new feature, which you’ve been working on for an hour.
This is probably a good size for a commit. All the work is on a single feature, so the commit will have a clear logical purpose. After an hour, the diff will probably have a fair amount of content in it, but not too much to understand.
On the other hand, sometimes after working for an hour you’ll have run into more than one natural committing point, in which case you would want to break the feature up into smaller commits. Because of this, “too big” could also be a reasonable answer here.
You fix two small bugs in different functions and commit them both at once.
This commit is probably too big. It would have been better to commit after the first bug fix, since the two bug fixes aren't related to each other.
Judgment Call
Choosing when to commit is a judgment call, and it's not always cut-and-dried. When choosing whether to commit, just keep in mind that each commit should have one clear, logical purpose, and you should never do too much work without committing.
What do you think are the pros and cons of manually choosing when to create a commit, like you do in Git, vs having versions automatically saved, like Google Docs does?
no trouble,but ,may be this is not the thing you want
What is a Repository
commite with Multiple file
problem:
after use git check out,how can we go back to the most recent id?
setting up the Git Workspace make it more easy to use
Changing background color
If you prefer the background color of Git Bash to be something other than black, you can change it in the "Defaults" menu under the "Colors" tab. If you like the background color as-is, you don't need to make any changes.
Downloading necessary files
Making Git configurations
Run the following Git configuration commands. The first one will need to be modified if you are using a text editor other than Sublime, or if Sublime is installed in another location for you. See this page for the correct command for a couple of other popular text editors. For any other editor, you'll need to enter the command you use to launch that editor from Git Bash.
git config --global core.editor "'C:/Program Files/Sublime Text 2/sublime_text.exe' -n -w"
git config --global push.default upstream
git config --global merge.conflictstyle diff3
Make sure you can start your editor from Git Bash
If you use Sublime, you can do this by adding the following line to your .bash_profile:
alias subl="C:/Program\ Files/Sublime\ Text\ 2/sublime_text.exe"
Restart Git Bash
You'll need to close and re-open Git Bash before all your changes take effect.
Supporting Materials
Lesson 2
A repositores
in a repositores
it contain a .git file,it store the data use by git
Initializing a Repository

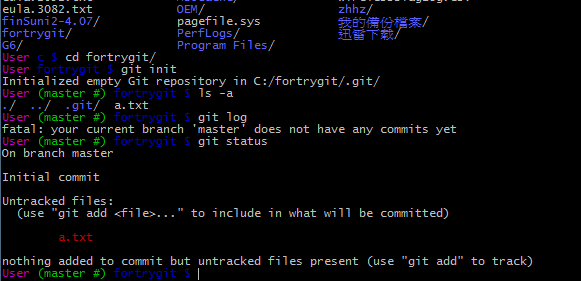

command
git init create a .git file
gir status show which file has change sice last commit

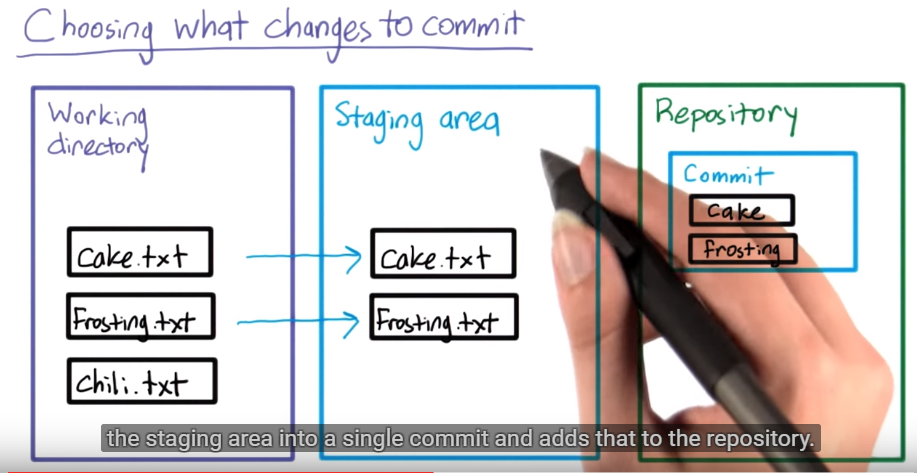

Staging Area

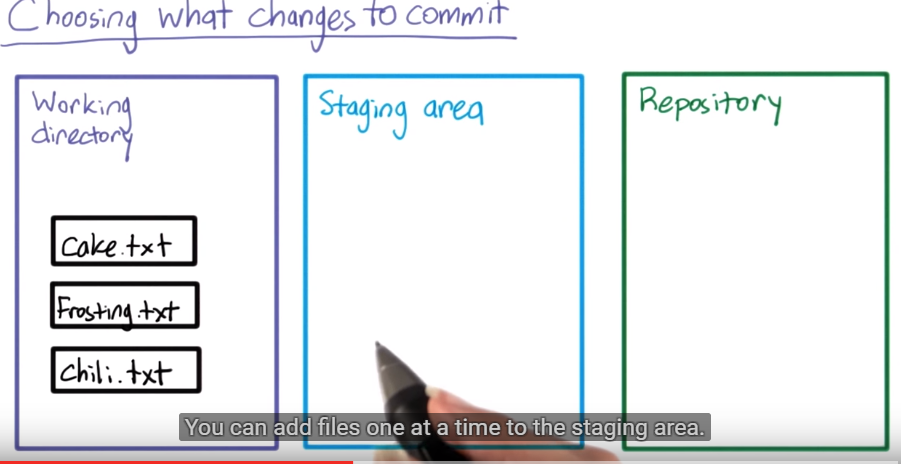

we can add file to the staging area
for example, i add cake.txt than add frosting.txt to the staging area,
than, a single commit,2 file together commited
code:
git add cake.txt
git add frosting.txt
remove
git reset lesson_2_reflections.txt
Writing Good Commit Messages
code:
git commit
git commit -m "Commit message"
How to write a goode Commit Messages
Commit Messages
Message Structure
A commit messages consists of three distinct parts separated by a blank line: the title, an optional body and an optional footer. The layout looks like this:
type: subject
body
footer
The title consists of the type of the message and subject.
The Type
The type is contained within the title and can be one of these types:
feat: a new feature
fix: a bug fix
docs: changes to documentation
style: formatting, missing semi colons, etc; no code change
refactor: refactoring production code
test: adding tests, refactoring test; no production code change
chore: updating build tasks, package manager configs, etc; no production code change
The Subject
Subjects should be no greater than 50 characters, should begin with a capital letter and do not end with a period.
Use an imperative tone to describe what a commit does, rather than what it did. For example, use change; not changed or changes.
The Body
Not all commits are complex enough to warrant a body, therefore it is optional and only used when a commit requires a bit of explanation and context. Use the body to explain the what and why of a commit, not the how.
When writing a body, the blank line between the title and the body is required and you should limit the length of each line to no more than 72 characters.
The Footer
The footer is optional and is used to reference issue tracker IDs.
Example Commit Message
feat: Summarize changes in around 50 characters or less
More detailed explanatory text, if necessary. Wrap it to about 72 characters or so. In some contexts, the first line is treated as the subject of the commit and the rest of the text as the body. The blank line separating the summary from the body is critical (unless you omit the body entirely); various tools like `log`, `shortlog` and `rebase` can get confused if you run the two together.
Explain the problem that this commit is solving. Focus on why you are making this change as opposed to how (the code explains that). Are there side effects or other unintuitive consequenses of this change? Here's the place to explain them.
Further paragraphs come after blank lines.
- Bullet points are okay, too
- Typically a hyphen or asterisk is used for the bullet, preceded by a single space, with blank lines in between, but conventions vary here
If you use an issue tracker, put references to them at the bottom, like this:
Resolves: #123 See also: #456, #789
|

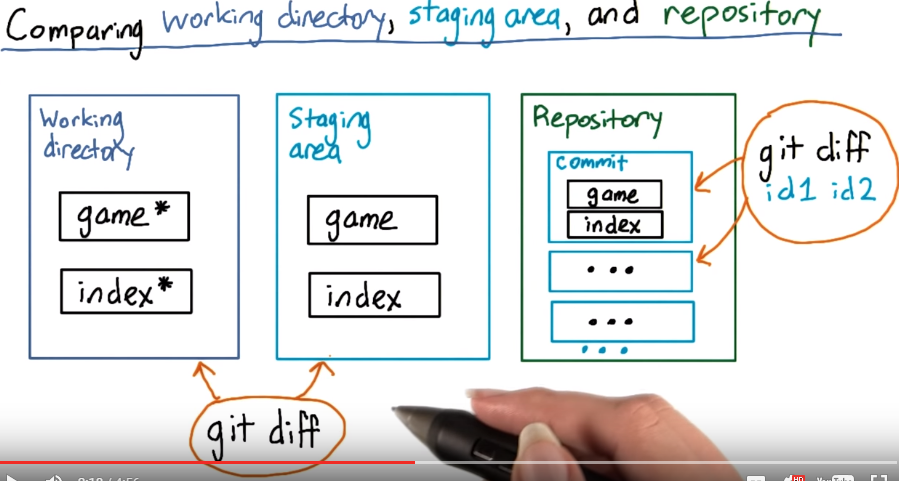

git diff Revisited
after a file modified,git status,
it show it is modified.
add to the staging area
and commint it again

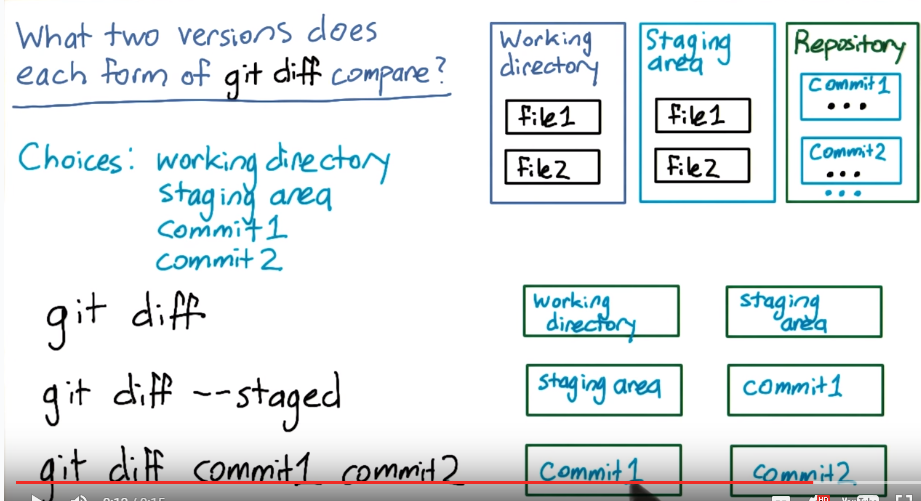

we can use git diff id1 id2 to compare two commit?
What about we want to compare the file in staging arae and working directory?
we can use
git diff
How about the difference between the staging arae and the recent commit?
git diff --staged
go back to the most recent commit for the working directory
staging area is empty
git reset --hard

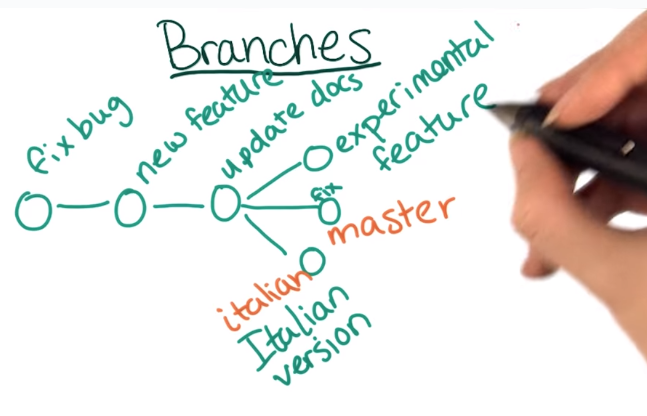

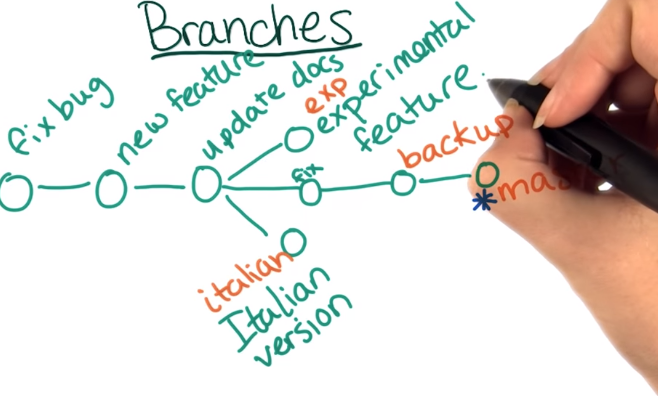

Branches
not just create linear commit
for each branches,will have a branche label on each most recent commit of each branch
and the branche label will auto update to the most recent commit
a single commit can have multi branche label
we check out a branch(by branch label),when update on this branch (branch label),new commit, like this
another one branch label (backup) will not move forward
code
create a branch
git branch will show current branch
git branch branch_mame create a new branch
from the start,we can see we currently at the master branch,although we have created the branch2 branch
git checkout branch2 go to other branch
than ,all commit will happen on this branch

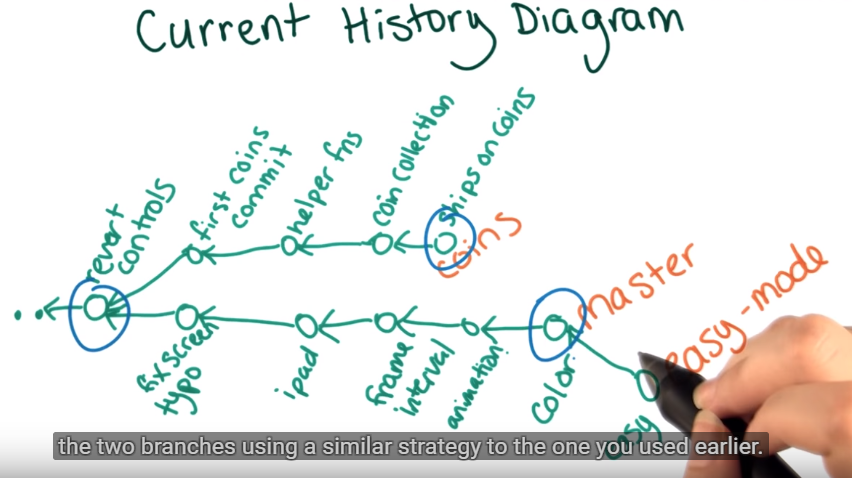

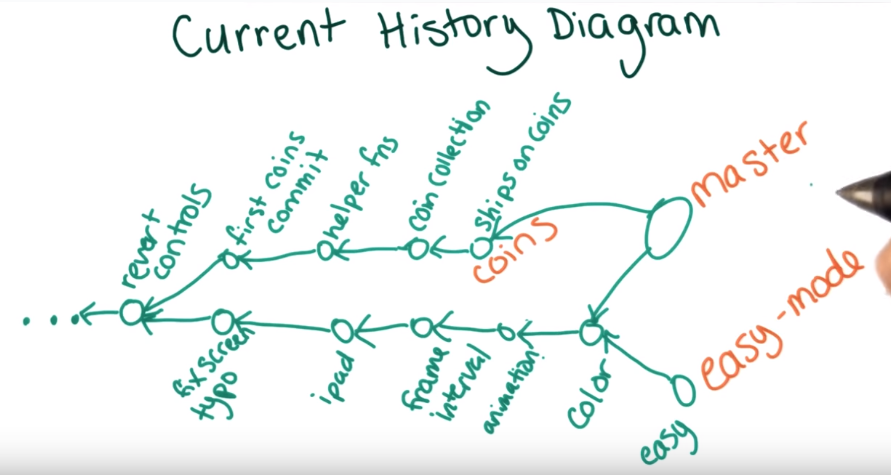

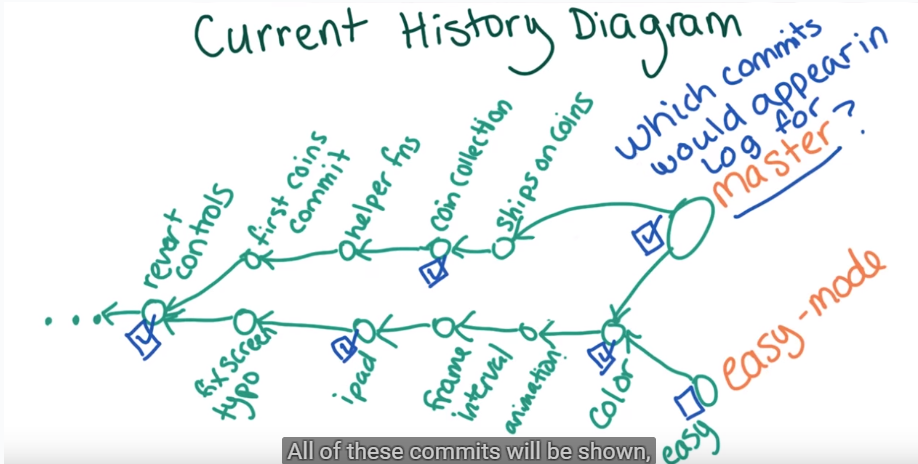

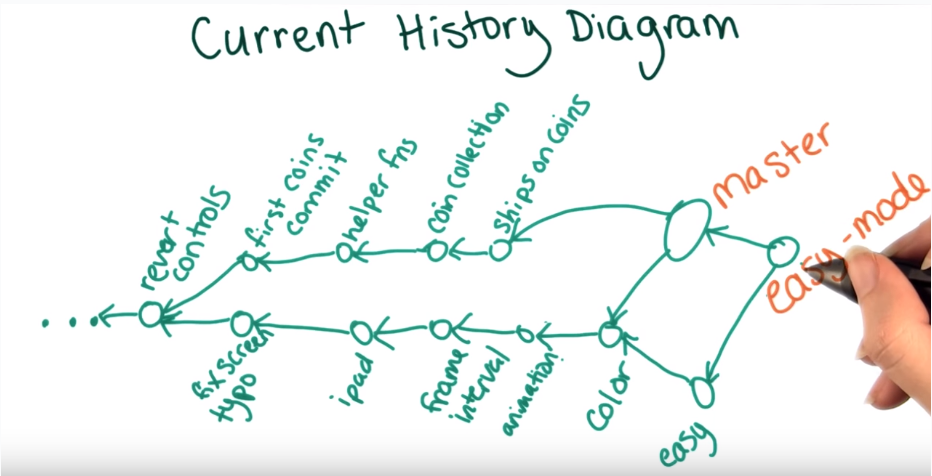

Viewing the commit history
code :git log --graph --oneline master coins
How to show the log?
we use git log,how the system show which log it show?

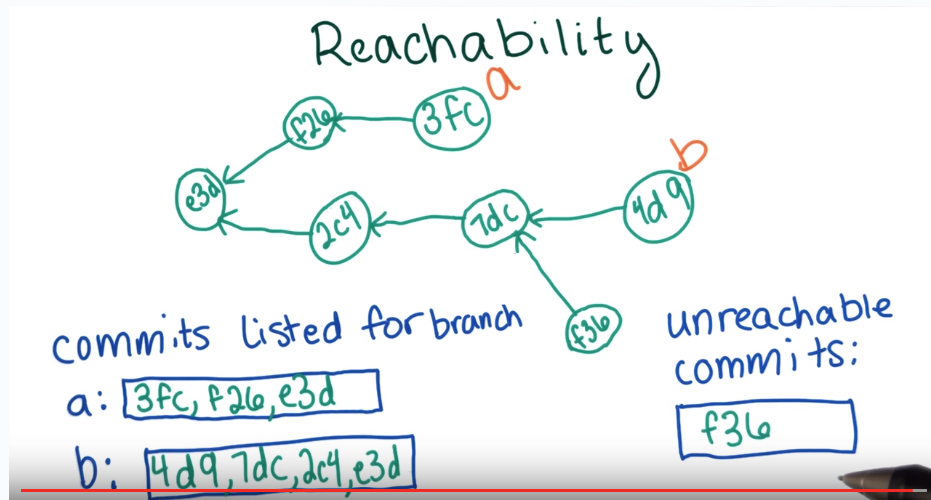

start with the id of the commit that the branch label is currently on, then trace back to its parent, then that commit's parent, and so on until you get to a commit with no parent. And remember to separate the commit ids with commas! Spaces are optional.
view the master and coin brance
Detached HEAD Revisited
when you type git checkput commitID,you will see the folloe
You are in 'detached HEAD' state. You can look around, make experimental
changes and commit them, and you can discard any commits you make in this
state without impacting any branches by performing another checkout.
If you want to create a new branch to retain commits you create, you may
do so (now or later) by using -b with the checkout command again. Example:
git checkout -b <new-branch-name>
HEAD is now at 19e279b... try commit first time
|
Head is current commit,
use above as a example,when type git checkout 7dc, HEAD is at 7dc, than make change ,than commit,will create f36
f36 not include in any branch,so will not show in the git log,show,if we lost the commit id,we can’t go back here
however,we can create a new bracnh for it
code:
git checkout -b new_bracng_name
we can see that the history in git is nolinear,

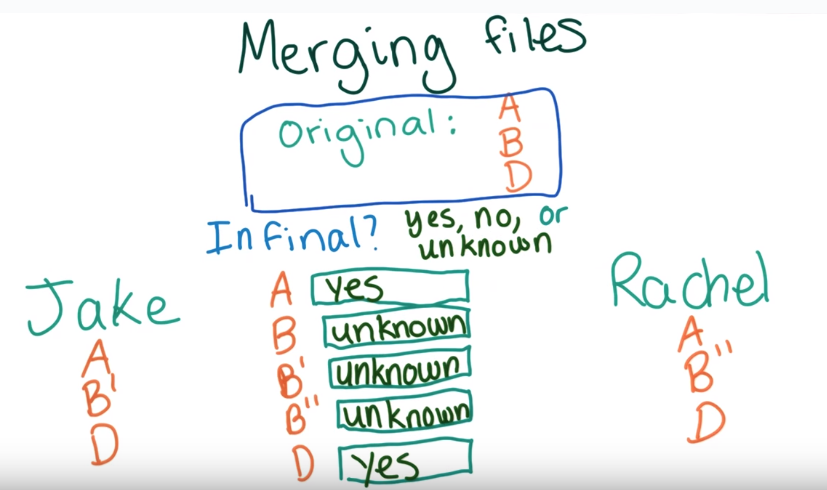

Combining Simple Files
how to solve the unknown?
if we have orginal file

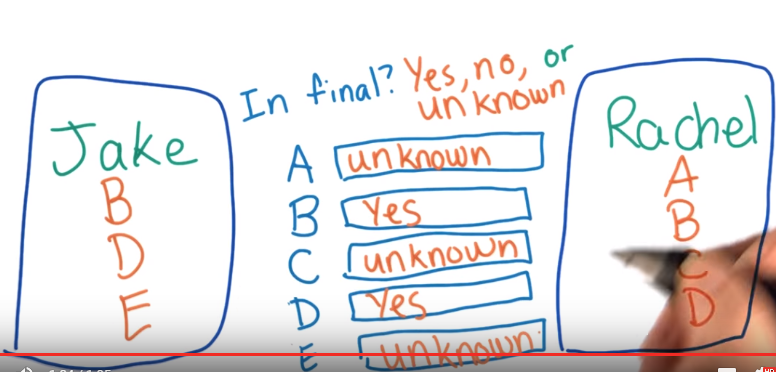

A should not keep,because Jake want to delete it from the orginal
C,E should keep,because Rachel add C and Jake add E,they are not in the orginal file.
Merging Coins into Master
need to use 3 point
and now is merge the coins branch into the master branch so
How will be the log after merge?
code:
first checkout branch2
git merge branch2 branch3
branch 3 merge into branch2
git show commit_id
can show the different between it parent,even you don’t know it parent
after megre 3 into 2, we can delete the label of brancg 3(not the commit)
git branch -d branch 3
Merge Conflicts
not always can auto merge
example:
A B D is different line
B’ is a modified version of B
B’’ is another modified version of B
A D must keep,but how about B’ and B”?
answer is unknown
Conflict Detection
how git detect the conflict?
decide by the user
EX marge
if master into the easy-mode branch,what will happen?
tips:merge create new commit.
Answer:
Resolving Merge Conflicts
saw this video:
Asteroid = function() {
this.breakIntoFragments = function () {
for (var i = 0; i < 3; i++) {
var roid = $.extend(true, {}, this);
roid.vel.x = Math.random() * 6 - 3;
roid.vel.y = Math.random() * 6 - 3;
if (Math.random() > 0.5) {
roid.points.reverse();
}
roid.vel.rot = Math.random() * 2 - 1;
roid.move(roid.scale * 3); // give them a little push
Game.sprites.push(roid);
}
};
this.collision = function (other) {
SFX.explosion();
if (other.name == "bullet") Game.score += 120 / this.scale;
this.scale /= 3;
if (this.scale > 0.5) {
<<<<<<< HEAD
// break into fragments
for (var i = 0; i < 2; i++) {
var roid = $.extend(true, {}, this);
roid.vel.x = Math.random() * 6 - 3;
roid.vel.y = Math.random() * 6 - 3;
if (Math.random() > 0.5) {
roid.points.reverse();
}
roid.vel.rot = Math.random() * 2 - 1;
roid.move(roid.scale * 3); // give them a little push
Game.sprites.push(roid);
}
||||||| merged common ancestors
// break into fragments
for (var i = 0; i < 3; i++) {
var roid = $.extend(true, {}, this);
roid.vel.x = Math.random() * 6 - 3;
roid.vel.y = Math.random() * 6 - 3;
if (Math.random() > 0.5) {
roid.points.reverse();
}
roid.vel.rot = Math.random() * 2 - 1;
roid.move(roid.scale * 3); // give them a little push
Game.sprites.push(roid);
}
=======
this.breakIntoFragments();
>>>>>>> master
}
};
};
|
merged common ancestors part is the code orginaly
master part(this.breakIntoFragments();) is the code in master
Head part is the code in the current branch
how to solve?decide by people,the conclusion is keep 1 of the 3 part ,andy delay the special 付號 is ok
Committing the Conflict Resolution
how to give the answer to the git?
saved the file,

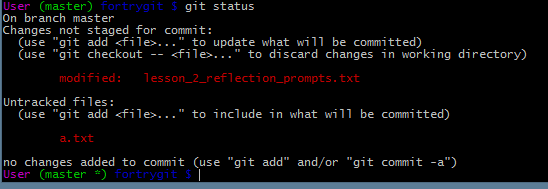

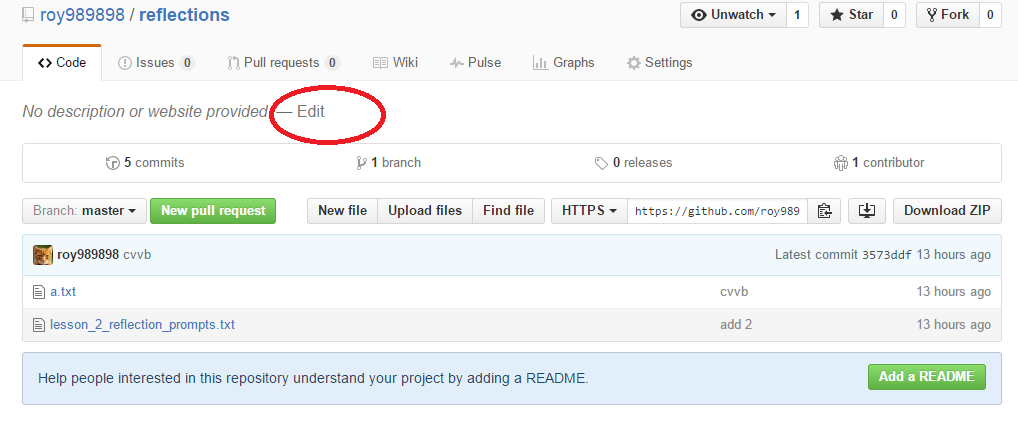

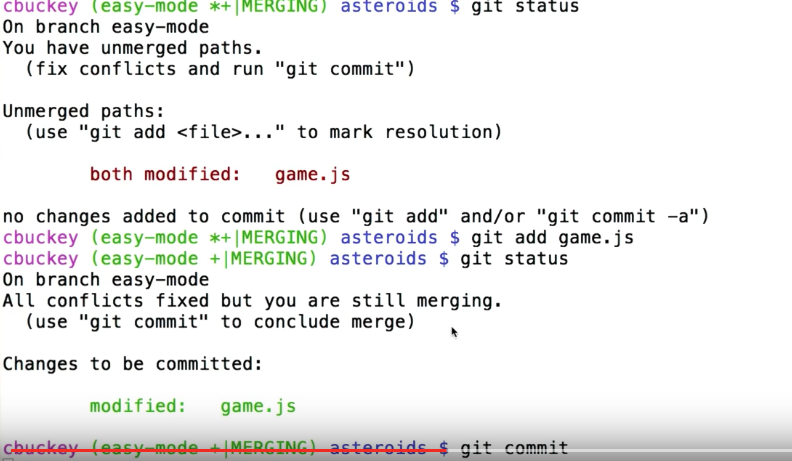

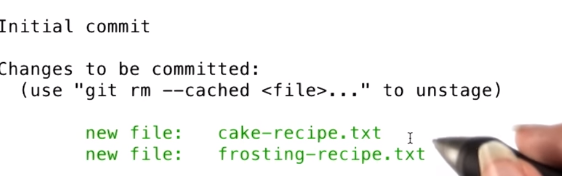

git status show below picture
git add
git commit
code summery lesson2
git init
|
create a .git file,create a respority
|
gir status
|
show which file has change sice last commit
|
git add cake.txt
git add frosting.txt
|
add the file to staging area
|
git reset lesson_2_reflections.txt
|
from staging area
|
git commit
git commit -m "Commit message"
|
create commit
|
git diff
|
compare working directory and staging area
|
git diff --staged
|
compare staging area and most recent commit
|
git reset --hard
|
go back to the most recent commit for the working directory
staging area is empty
|
git branch
|
will show current branch
|
git branch branch_mame
|
create a new branch
|
git checkout branch2
|
go to other branch
|
git log --graph
|
show the log as a picture
|
git log --graph --oneline master coins
|
show the log in branch master and branch coins as a picture
|
git checkout -b new_bracng_name
|
=f
irst
git branch branch_mame
than
git checkout branch2
|
first checkout branch2
git merge branch2 branch3
|
branch 3 merge into branch2
|
git show commit_id
|
can show the different between it parent,even you don’t know it parent
|
git branch -d branch3
|
delete the branch3 label
|
|
|
|
|
|
|
|
|
|
|
GitHub

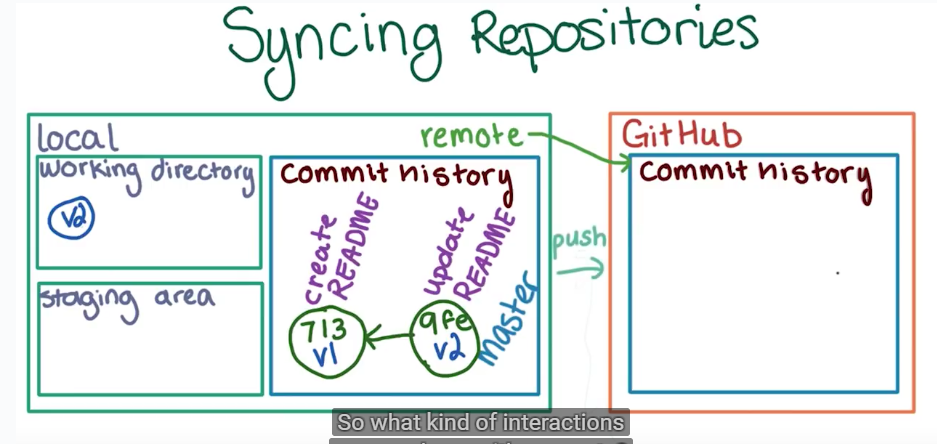

GitHub only contain commit hostory.
push
first ,we need to create a new repository at git Hub,a remote repository
local has a repository too.
we can push and pull data
the data that we send and receive is commit
but not the individual commit,is a branch
EX

when push branch A,will push e53 to the GutHub first,than track back send fd2,because a3b already on the server og Github,so no send a3b

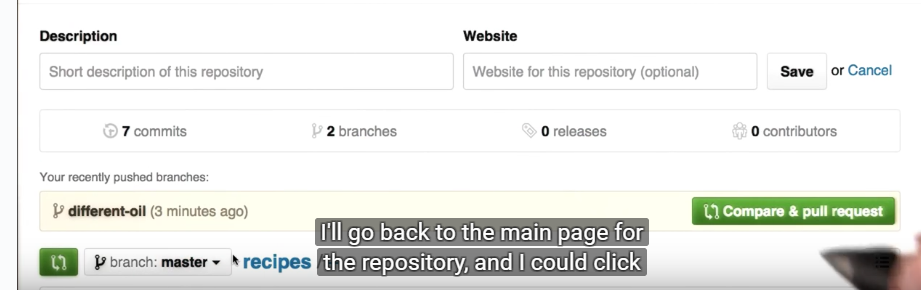

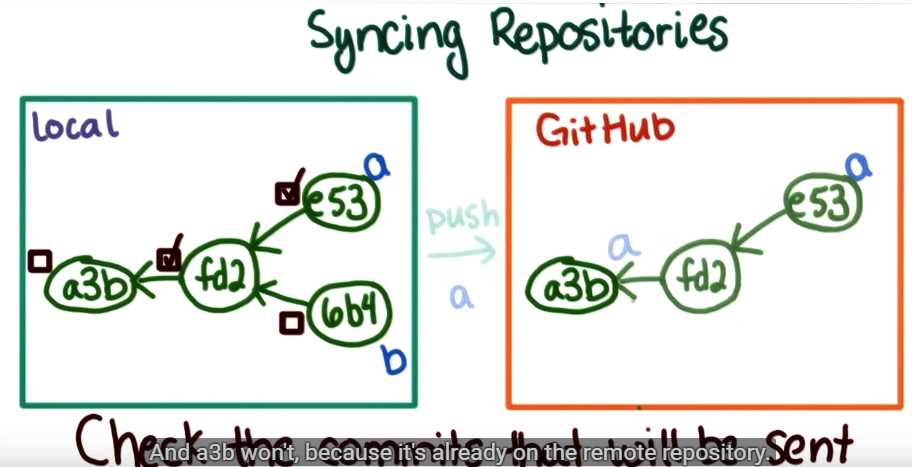

Push your branch to the github
git remote add origin git@github.com:roy989898/reflections.git
git push -u origin master
the origin is the remote name,can be any name
the url is get from git hub should Copy the HTTPS URL, not the SSH URL!

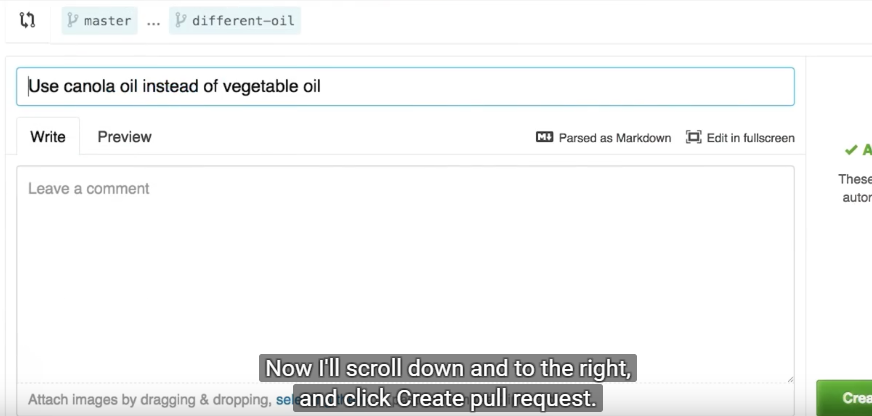

Editing Files on GitHub
we can create and edit file directly on the github
but the change will not appear at the local
Pulling Changes

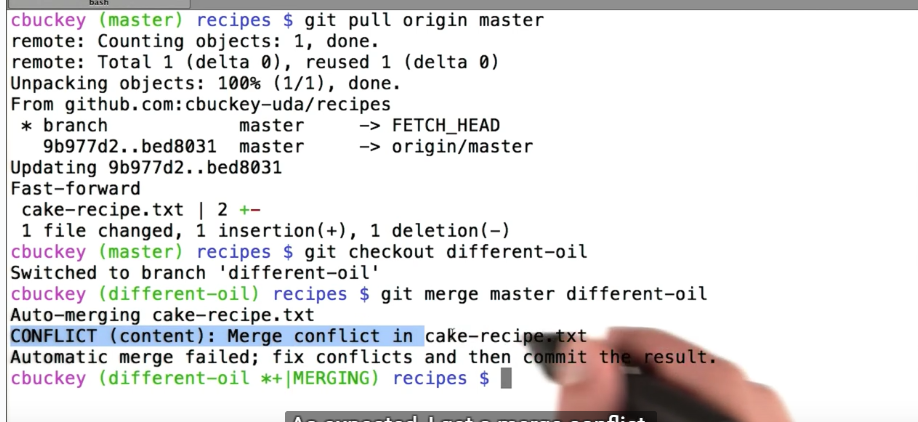

git pull origin master

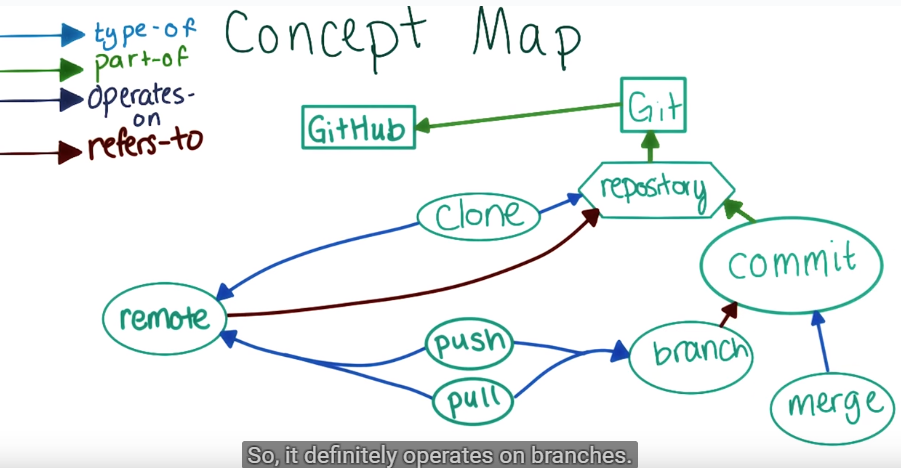

Concept Map: GitHub, Push, Pull, Remote

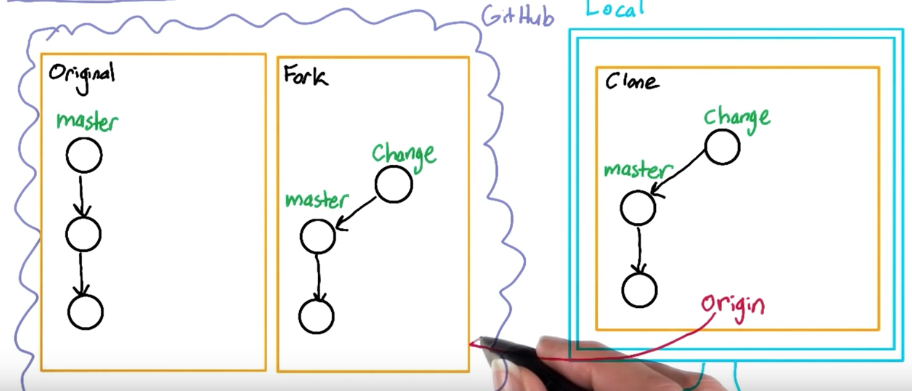

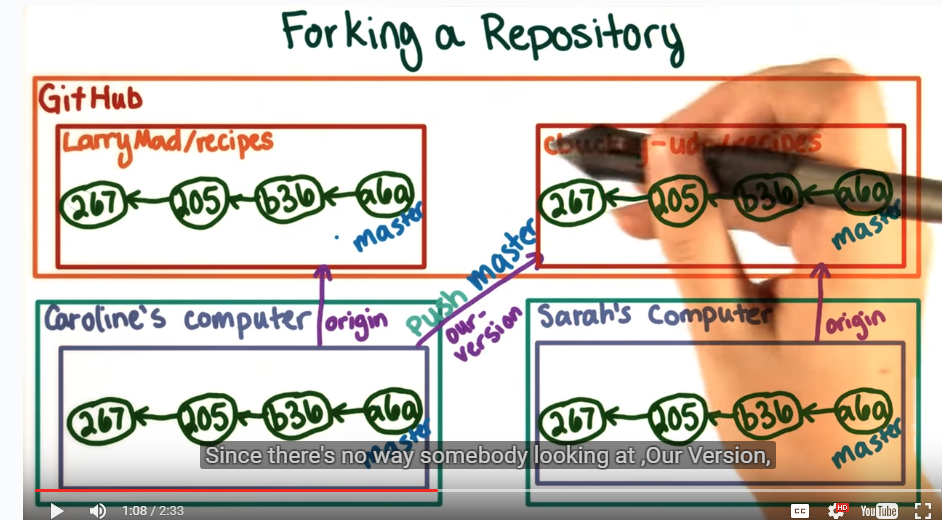

Forking a Repository
Traditionaly

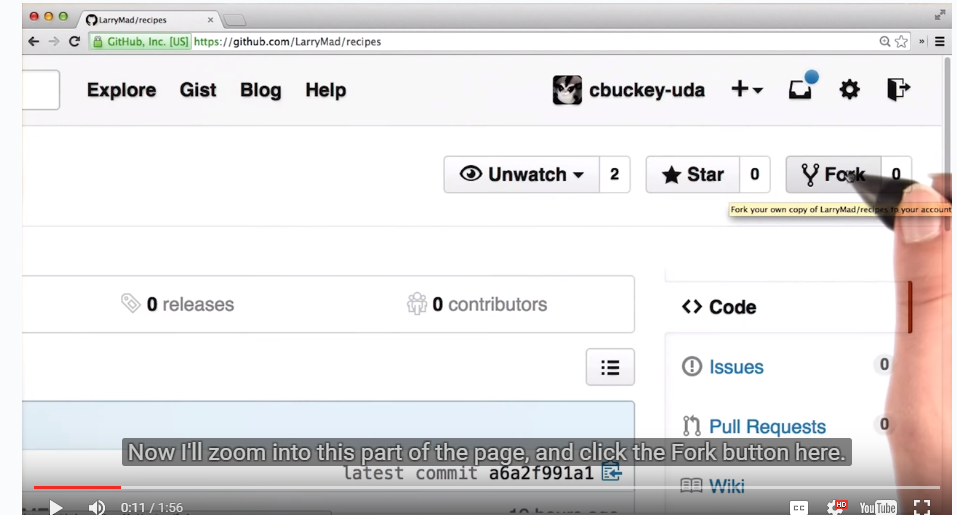

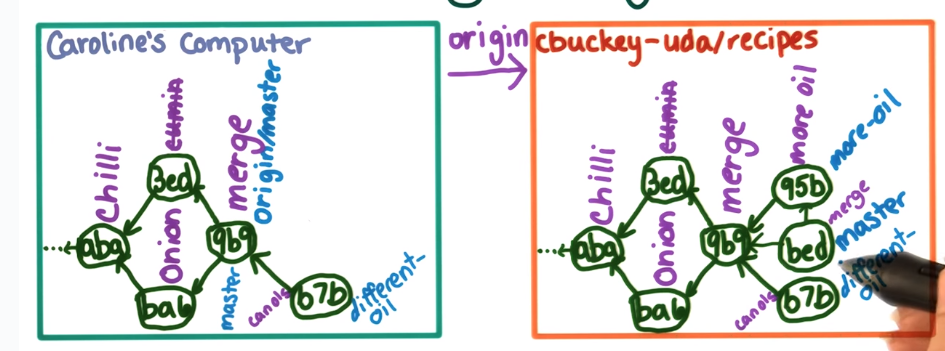

if i share a github Repository, other people*Caroline( want to get it use clone,clocne to their local machine,
for the clone,auto create a remote call origin
when Caroline want otpush to GitHub(her own account),need create another remote call our-version,than push the master
Use fork
little step
directly to your account
Fork the Recipes Repository
use git clone to cloe to the local
aouto create a remote
can push and pull
Add Collaborator
other people can push to your Repository too.
click setting,>Collaborator>add
EX
try this
Larry's repository on GitHub can be found here.
Collaborations Cause Conflict
EX
for this first:
Larry's repository on GitHub can be found here.

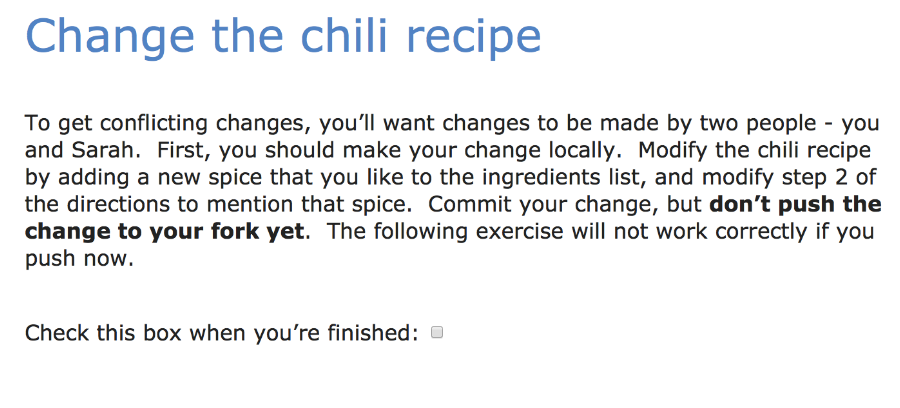

Simulate Sarah's Changes
In the Downloadables section, there is a file called sarah_changes.sh, which contains code to make it look like Sarah has modified your fork on GitHub. To run the code, download the file, then using Git Bash or your terminal, cd to the directory where you've saved it. Then type bash sarah_changes.sh followed by a space, followed by the url to your fork. For example, if Caroline were running the code, she would type bash sarah_changes.sh https://github.com/cbuckey-uda/recipes.git, but you should use the url for your fork, not Caroline's fork. If you haven't set up password caching, then you will be prompted to enter your GitHub username and password.
Updating Local Copies of Remote Branches,Fetch nad Pull
\at the begning ,we clocne the Repository to local,aouto create a remote call orihin that point to the cloned github
show will will see a branch call master at local
actually,at the local has another branch,but we haven’t see that, it indicate the last known position of the remote, the name is remote_name/remote_branch_name(origin/master)
when we make commit on the master local branch
orihin/master at the same location,because we don’t communicate to the github yet
if we push the master bracnh
how about if github changed,and local change too?

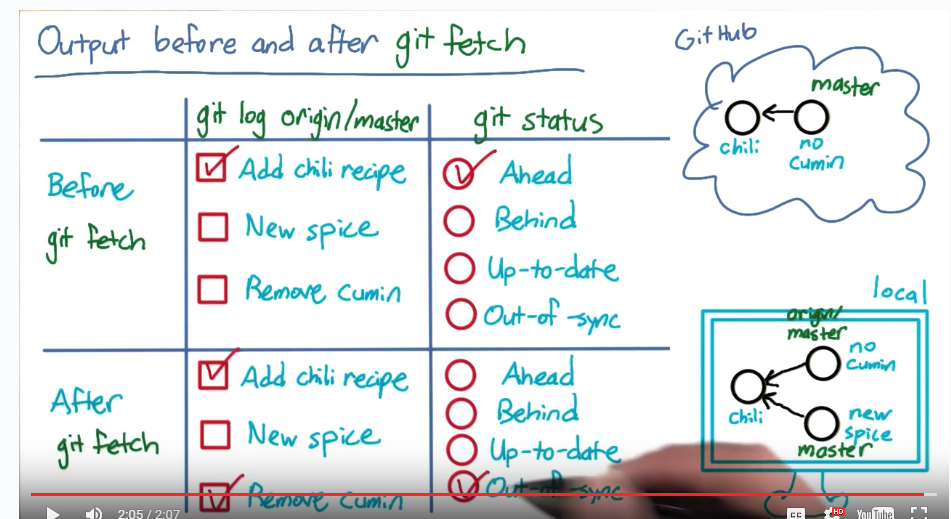

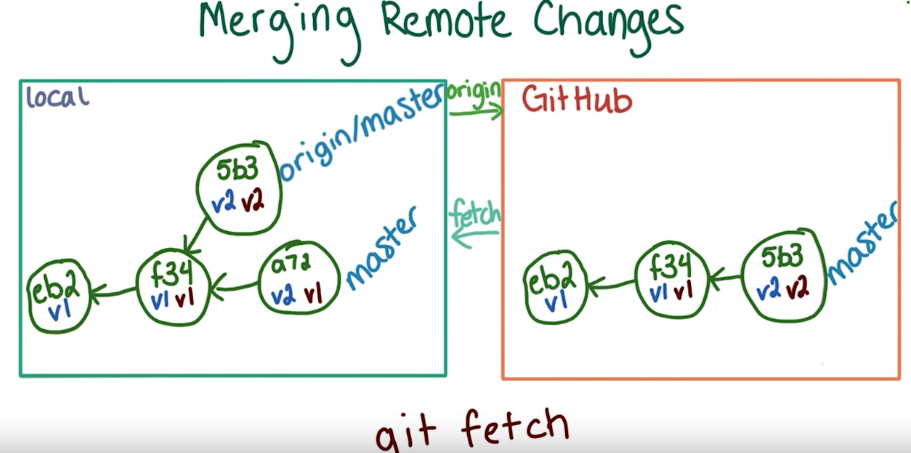

than call fectch
will create a new commit at local,will not combined
we need combine by ourself.
merge orginal/master into master
for pull:
do:
Ex:
out of sync because no conectbetween orihin/master and the master branch
Merging the Changes Together
fiirst checkout master branch
code: git merge master origin/master
solve the conflict
git add> git commit
EX:

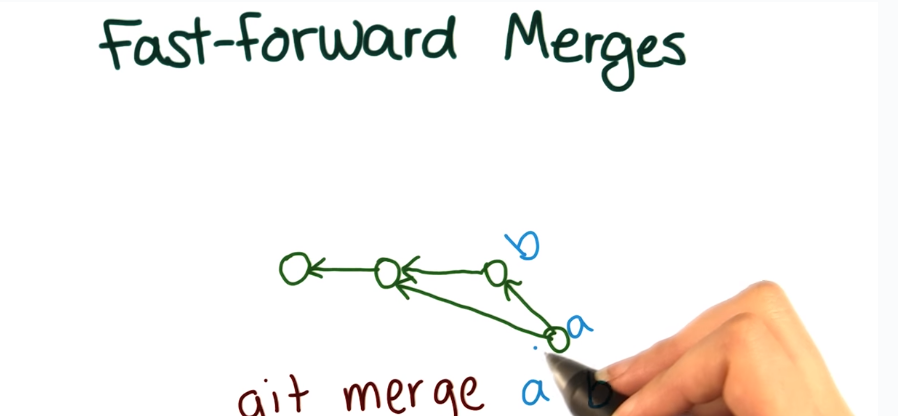

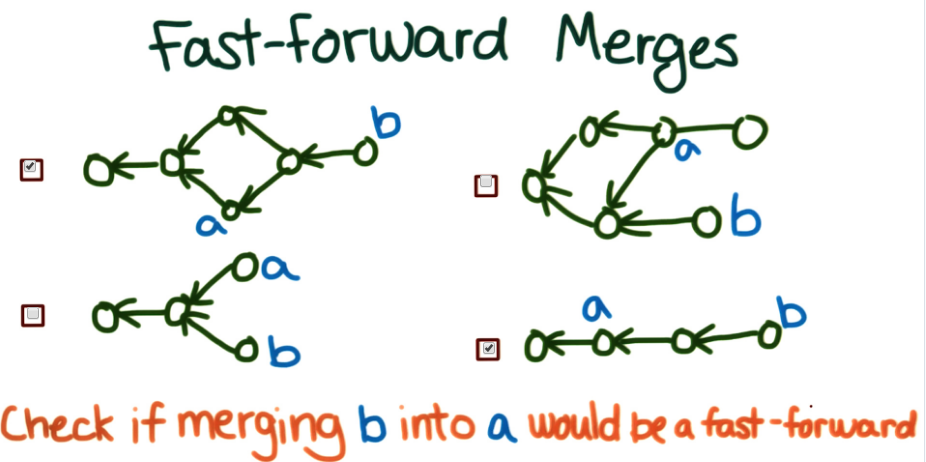

Fast-Forward Merges
if merge b into a,what happen?
should be like this.
howeer,
because b already have all the information of A,show actually ,just move the aA label forward
EX

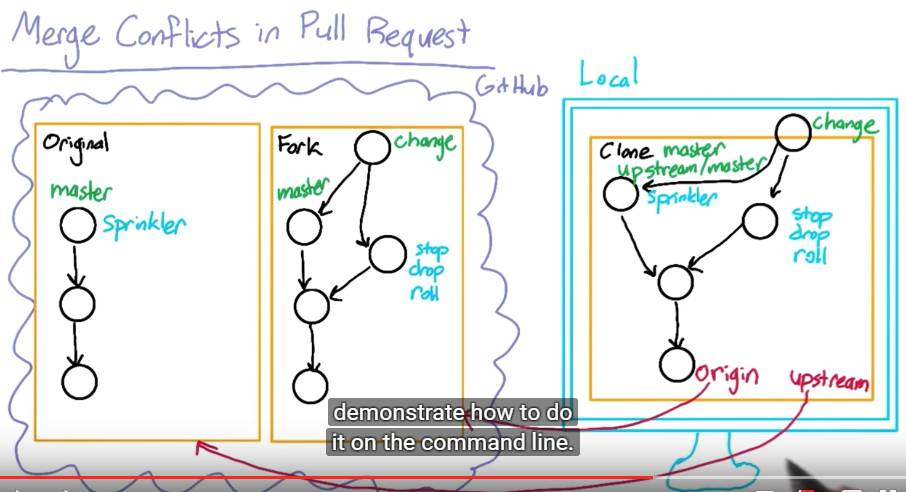

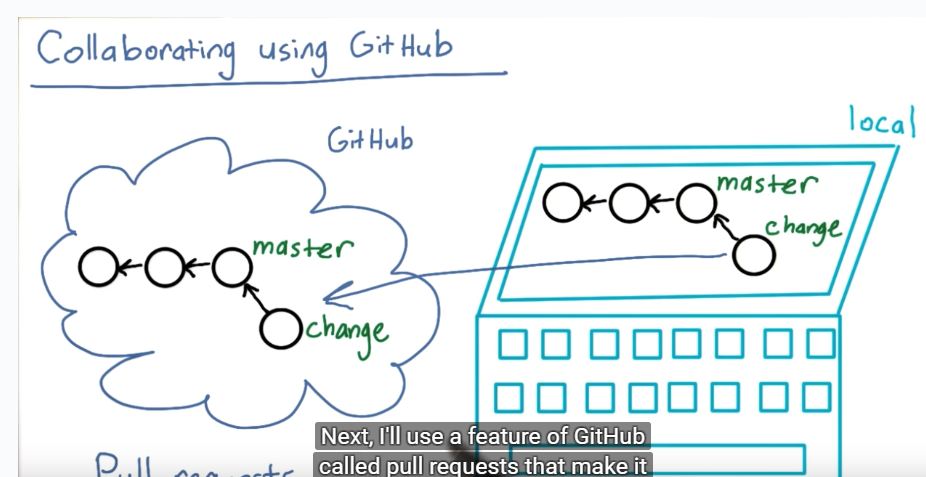

Making a Pull Request,collect the feeback before update to the master branch
we can make a change on a sperate branch,call change,than push it to the github
fially,get ready,mege them
at github
create a new pull request to the different-oil brancg
choose like this,
not the people you fork for
than other people, will se the pull request,receive email.and comment it
EX
soultion
*******
Sarah accidentally says that the local master is the only thing that changes when you run git pull origin master. However, the working directory and staging area will also update when you run git pull. That's why when you run git pull, you see your files update, not just the git log output.
Updating a Pull Request
make a commit,than push to github, Pull Request auto update

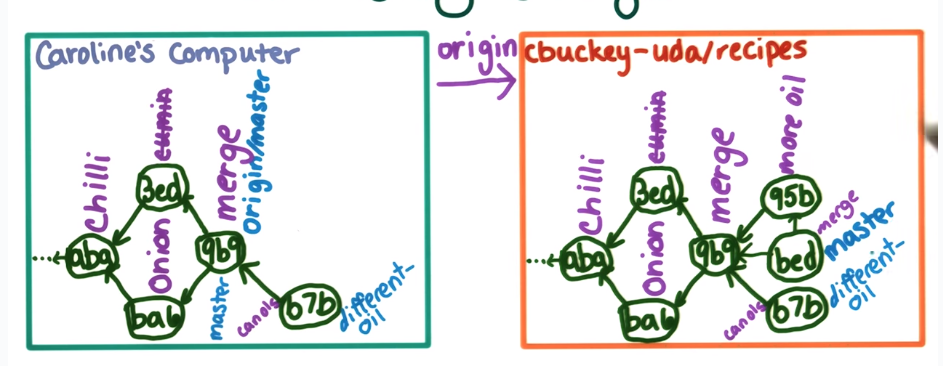

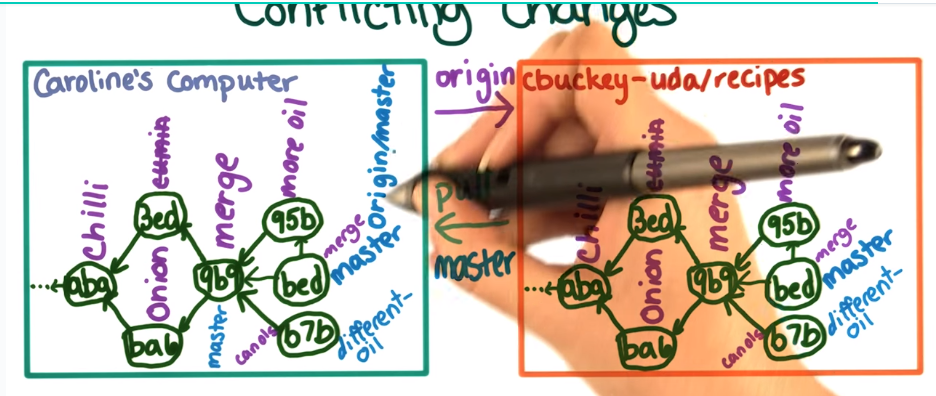

Other Collaborater update the same file or same line ,Conflicting Changes
on githuib,other Collaborater add more oil,i add different oil
on the Github wesite,we can merge the pull request on the website:
like this:
we clickthe button for more oil pull request
no,Fast-Forward Merges,github always create a new commit
and the more oil branch will delete by the github
all the thing above happen in the GitHub
than Carolin pull
we can see that the orgin/master is a the bed at lacal,it is because at last cmoounicate,the master at bed in gihub
finally ,we merge them,
Carolin want to get her change onto the master branch,we can just direstly merge it in to the Master branch like before,However
this can not let other people, what you change,.So, we caret a h,a new commit at different,pull request auto update, to solve the conflict,, than merge the different oil into the Master
,so we see one more commit(e47).
why merge master into different _oil first?anove have the answer
EX
Simulate Sarah's changes
To simulate Sarah's changes, first download the file sarah_changes_2.sh from the Downloadables section. Then, using Git Bash or your terminal, cd to the directory where you've saved the file. Then type bash sarah_changes_2.sh followed by a space, followed by the url to your fork. For example, if Caroline were running the code, she would type bash sarah_changes_2.sh https://github.com/cbuckey-uda/recipes.git, but you should use the url for your fork, not Caroline's fork. If you haven't set up password-caching, then you will be prompted to enter your GitHub username and password.
Note: This code will not actually create a pull request. Instead, it will update the commit history on GitHub to make it look as though the pull request has already been merged. You will not need to merge a pull request. Instead, check for a commit on the master branch on GitHub with the message "Merge pull request".
Make sure you are on the master branch
You'll want to make sure you check out the master branch before following the steps in this video. You'll want to make sure you check out the master branch before following the steps in the instructions video.
Use git add on the conflicting files before committing
Just as in lesson 2, before running git commit to create the merge commit, you'll need to use git add to add any files that had conflicts to the staging area.
Supporting Materials
|

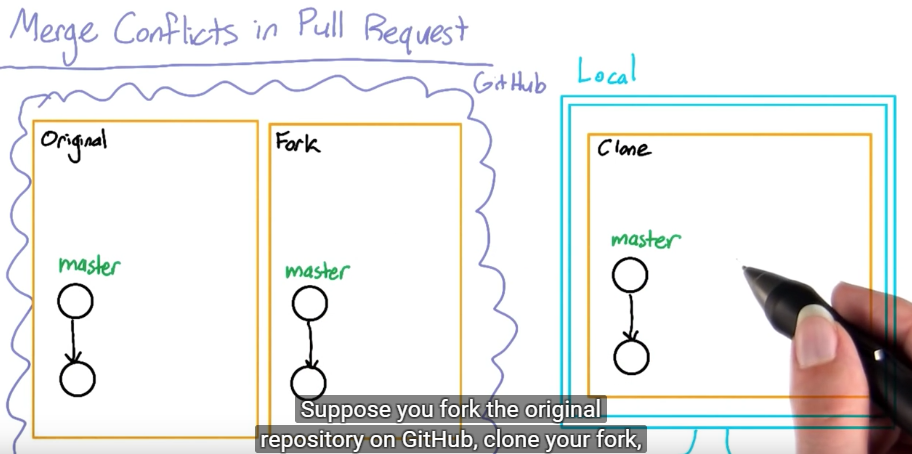

Keeping a Fork Up-To-Date
at the original,we fork and clone
than,the orginal has cahnge,we have make other change on the local,and push back to the fork
because of the conflicts,the fork and original can not merge.

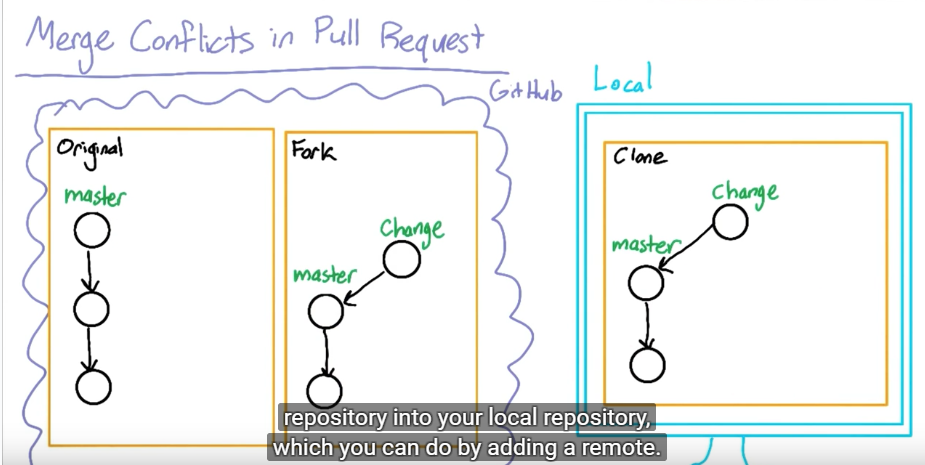

so,we need to download the original to the local clone.
we already has a origin remote to the fork,because of the fork
we create another remote call upstream,and fectch it,create a upstream/master branch
between upstream/master and change has conflict
merge the upstream/master into master first,than merge master branch into the change branch
than push them to the fork(change branch and master branch)
finally,merged.
code summery
git remote
|
see remote have at the local
|
git remote add origin(name) HTTPS URL
|
add the remote repository to the local
|
git remote -v
|
show the information
|
git push -u origin master
|
push the master branch to the origin remote repository
|
git pull origin master
|
pull the commit form the remote to the local
=git fetch origin+
git merge master origin/master
|

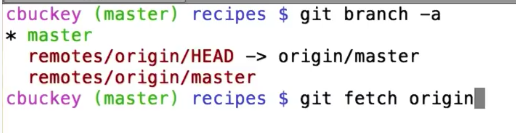

git branch -a
|
List both remote-tracking branches and local branches.
|
git fech origin
|
updat all local copy of every branch for the origin remote
|
check out master
git merge master origin/master
|
merge the master origin/master
|
|
|
